One continuous view of a playground project: design office, steel workshop, pre-assembly yard, a loaded container and an installed park playground
  1. 01Site plan
  2. 02Layout + quotation
  3. 03Drawing approval
  4. 04Production · 20–30 days
  5. 05Pre-assembly
  6. 06QC + packing
  7. 07Loading plan
  8. 08Installation

Home › How We Build Playgrounds

Project timeline · 8 steps · 3 confirmation points

How We Build Playgrounds Layout Design, Steel and Rotomolding, Safety Testing and Installation Support

Playground equipment manufacturing for commercial projects, run as one timeline from your site plan to your installed playground, with three points where you confirm before the container leaves.

  • Layout + itemized quotation in 3 working days
  • Production 20–30 days after approval
  • Photo updates at 4 points
  • Electronic project package with the shipping documents
02/ 13 · Project timelineSteps 01–08

Project Timeline Eight Steps From Site Plan to Installed Playground

This is how playgrounds are built on a commercial project, step by step: what happens, what you receive and where the full process is explained. From drawing approval the playground project process runs on two tracks, one in the factory and one on your site.

01Site information

Site plan or dimensions, age groups, visitors, theme, budget range and your standard. Anna replies within 24 hours.

You receive
Your project manager

02Layout and quotation

The design office draws your site in 2D and 3D; the itemized quotation comes with it.

You receive
2D plan · 3D renders · quotation

03 · Confirm 1Drawing approval

You approve the drawing. It becomes your installation drawing, with footing drawings for every post.

You receive
Installation + footing drawings

04Production

Steel, rotomolding, soft play sewing and partner orders start in parallel on the approval day.

You receive
Photos at start and after coating

05 · Confirm 2Pre-assembly

Outdoor structures are assembled complete in the yard; indoor frames are trial-assembled.

You receive
Photos and video, before packing

06QC and packing

Parts are checked against the packing list and packed in installation sequence, with a spare hardware kit.

You receive
Packing list keyed to part numbers

07 · Confirm 3Loading

You confirm the loading plan before the container is booked.

You receive
Loading photos of each container

Your site, same drawingWith the footing detail drawings from step 03, your installer can excavate, pour footings and apply for permits while production runs.

08Shipment and installation

Shipping documents and your project package arrive together. Your installer builds from footing drawings and numbered parts.

03/ 13 · Layout and quotationStep 02

Layout and Quotation Returned Together Within 3 Working Days

The first file you receive is a drawing of your own site with a price against every piece on it.

3Working days · layout and itemized quotation, together

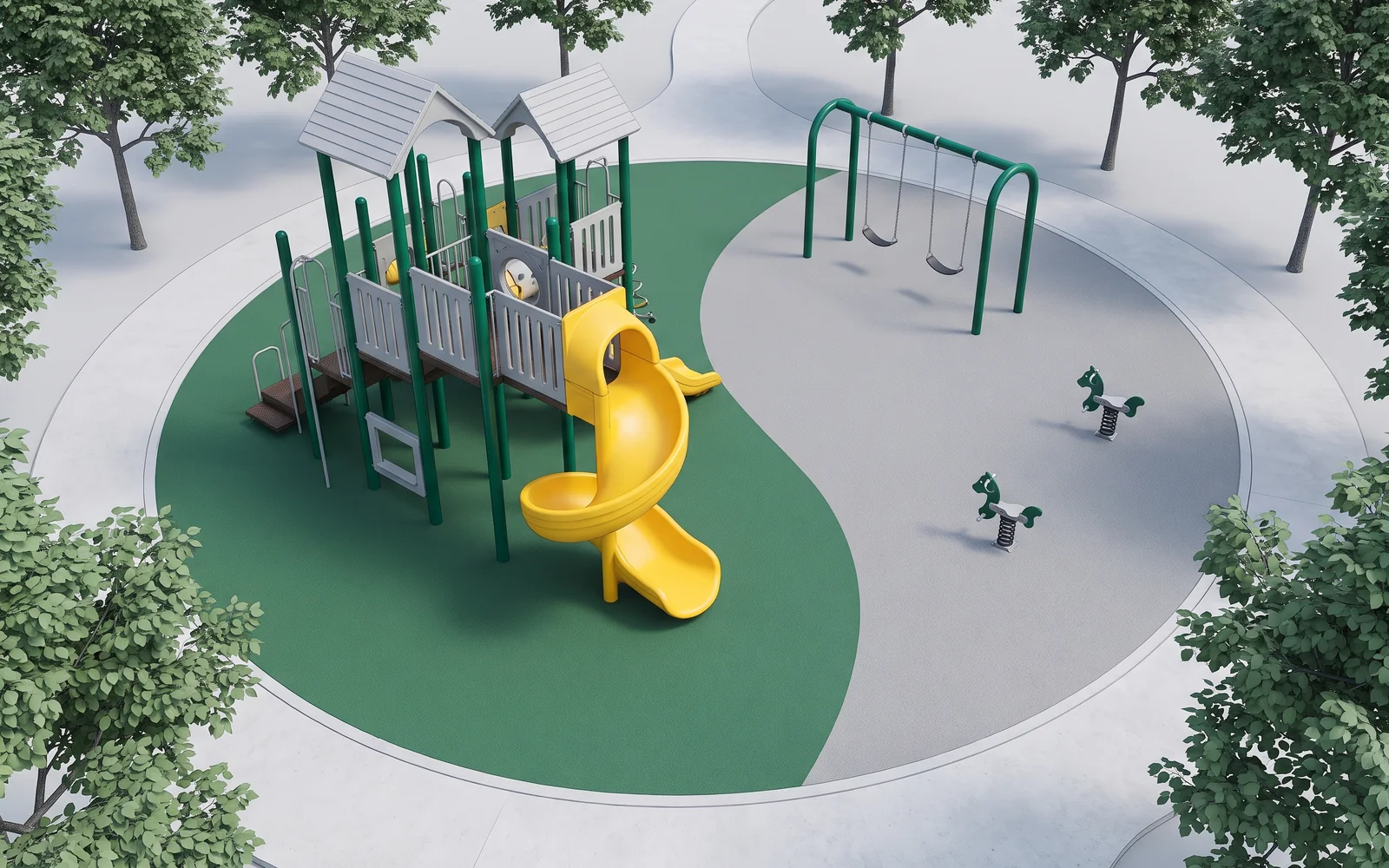

3D render of a park playground layout with a multi-deck structure, a spiral slide, swings and two age zones3D render · your theme and colors

A printed 2D site plan with structure footprints, use zones and age zones2D plan · age zones · use zones · surfacing

A designer drawing a play structure at a CAD workstation
Itemized quotation · excerpt
ItemSpec sheetCompliance
Multi-deck structure S1Posts Ø114 × 3.0 mm, galvanized and powder coated · 19 mm HDPE panels · 304 stainless fastenersASTM F1487 / EN 1176
Spiral slideRotomolded UV-stabilized LLDPE, 8 mm wallASTM F1487 / EN 1176
Climbing net16 mm six-strand rope with steel coreASTM F1487 / EN 1176
SurfacingRubber tiles or EPDM, thickness by critical fall heightASTM F1292 / EN 1177

Every line priced · spec sheet per line

What the design office draws

The 2D plan places every structure and freestanding piece on your ground, with age zones, use zones and the surfacing under each piece. The 3D renders show the same site in your theme and colors, ready for a client, a board or a tender panel.

What the quotation carries

Your project manager prices the layout item by item. Each line has its material spec sheet: post diameter and wall, coating, panel thickness, rope and fasteners. The compliance documents for your standard are listed on the same quotation.

How revisions work

Comment on the layout and the design office returns a revised layout, with the quotation updated to match. Revisions continue until you approve.

For dealers

Layout, renders and quotation can be issued unbranded or under your brand, from your first request. Custom themes, colors and logos are drawn at this step too: custom playground solutions.

04/ 13 · Safety standardsSteps 01–03

Safety Standards on Your Project Named at Step One, Drawn and Listed on the Quotation

The standard enters your project with your site information, and every later file follows it.

Your market

01Site information

You name the standard your project must follow.

ASTM F1487 + CPSCEN 1176 + EN 1177

A layout on a design office screen with dashed use zones around a slide exit and swings

02Layout

The design office draws to it: use zones, fall heights, entrapment gaps and protective barriers above the set platform heights.

ASTM F1487 + CPSCEN 1176 + EN 1177

A printed quotation open at its compliance document list

03Quotation

The compliance documents for that standard are listed line by line.

ASTM F1487 + CPSCEN 1176 + EN 1177

04Approved drawing

Workshops make to it, and QC checks against it.

ASTM F1487 + CPSCEN 1176 + EN 1177

USA

ASTM F1487 + CPSC
Outdoor equipment, with the CPSC Public Playground Safety Handbook
ASTM F1292
Surfacing
ASTM F2373
Areas for children under 2
ASTM F1918
Indoor soft play
ASTM F2970
Trampoline courts
ASTM F3101
Outdoor fitness
ASTM F1951
Accessible surfacing

UK, EU and Australia

EN 1176
Playground equipment
EN 1177
Surfacing
EN 16630
Outdoor fitness

Inclusive layouts follow ADA accessible-route principles. Third-party testing, and fire testing of soft play materials, are arranged per project on request.

05/ 13 · Drawing approvalStep 03

Drawing Approval What Locks and What Is Issued on the Approval Day

Drawing approval turns your layout into a production order. It is your first confirmation point, and it starts two lines of work at once: one in the factory and one on your site.

Before you sign

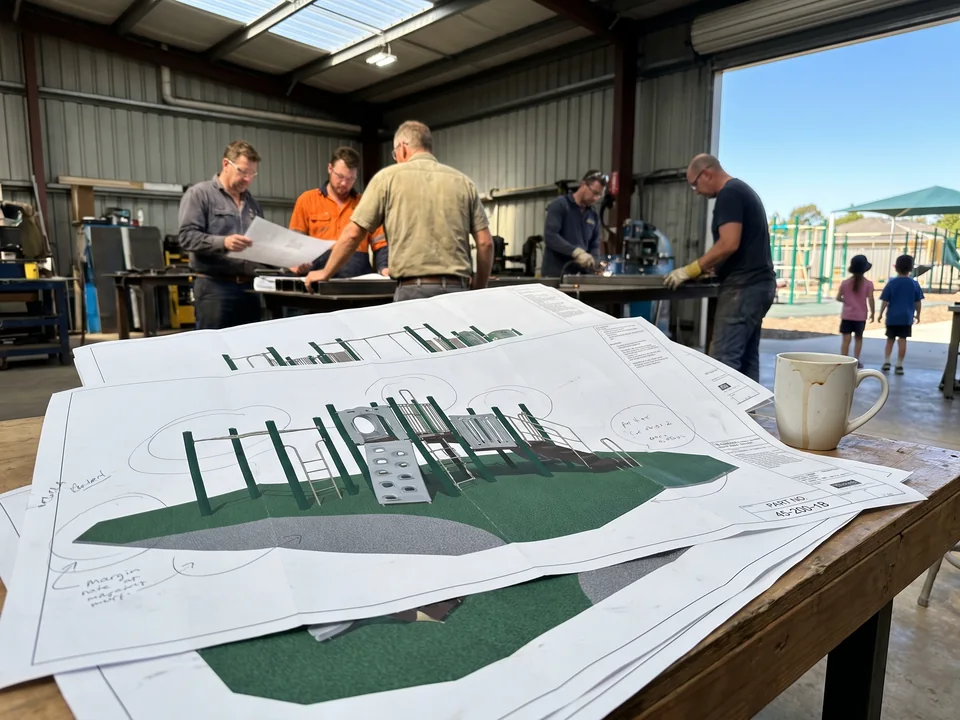

Three printed layout revisions overlapping on a table with pencil notes

What you approve

The drawing shows every structure, its position and its parts. For custom work it also carries theme elements, colors and logos.

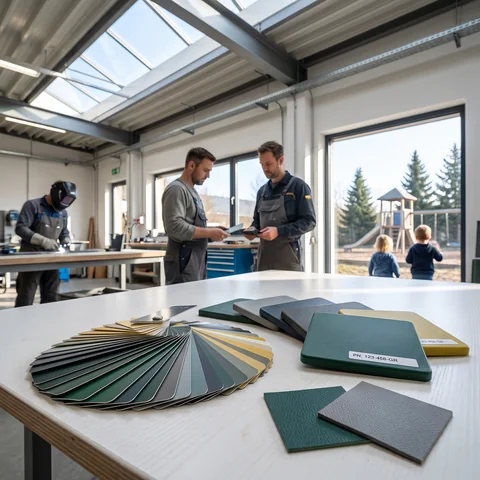

RAL color chips, rotomold color samples and PVC leather swatches on a table

Custom colors are confirmed before production with RAL chips, rotomold color samples or PVC leather swatches, sent or photographed for your approval.

After you sign

What locks when you sign

  1. 01The layout and every structure on it
  2. 02All customization: theme elements, RAL colors part by part, logo positions
  3. 03The part numbers, in the {structure}-{part} format, kept through every later fileS2-021
  4. 04The reference QC checks every part against

What is issued from the approved drawing

Dwg · installation

The approved drawing becomes the drawing your installer builds from.

Dwg · footing detail · every post

Every post, shade posts included, gets a concrete footing size.

Orders · steel, rotomolding, sewing

Cutting and welding, rotomolding and soft play sewing start on the approval day, in parallel.

Orders · partner factories

Inflatables, rides, splash pad parts, surfacing, shade sail fabric, jump beds and springs, ordered the same day to the same drawing.

Date · loading

Your project manager sets one loading date that every workshop and partner factory is scheduled back from.

See the schedule
The approval day · two places start

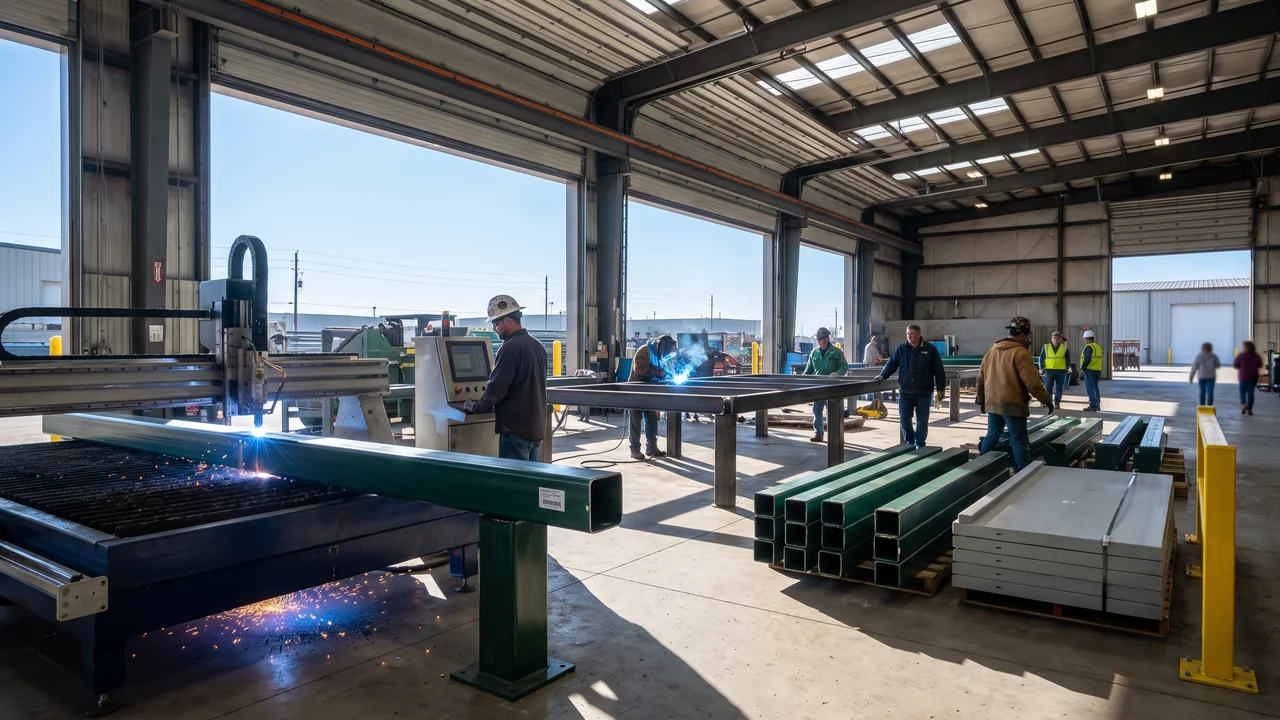

A CNC tube cutter cutting the first evergreen steel posts of a new order

In the workshops and partner factories

Supplied with your order

  • Installation drawings
  • Footing detail drawings
  • All equipment, as numbered parts
  • Anchoring hardware for every post

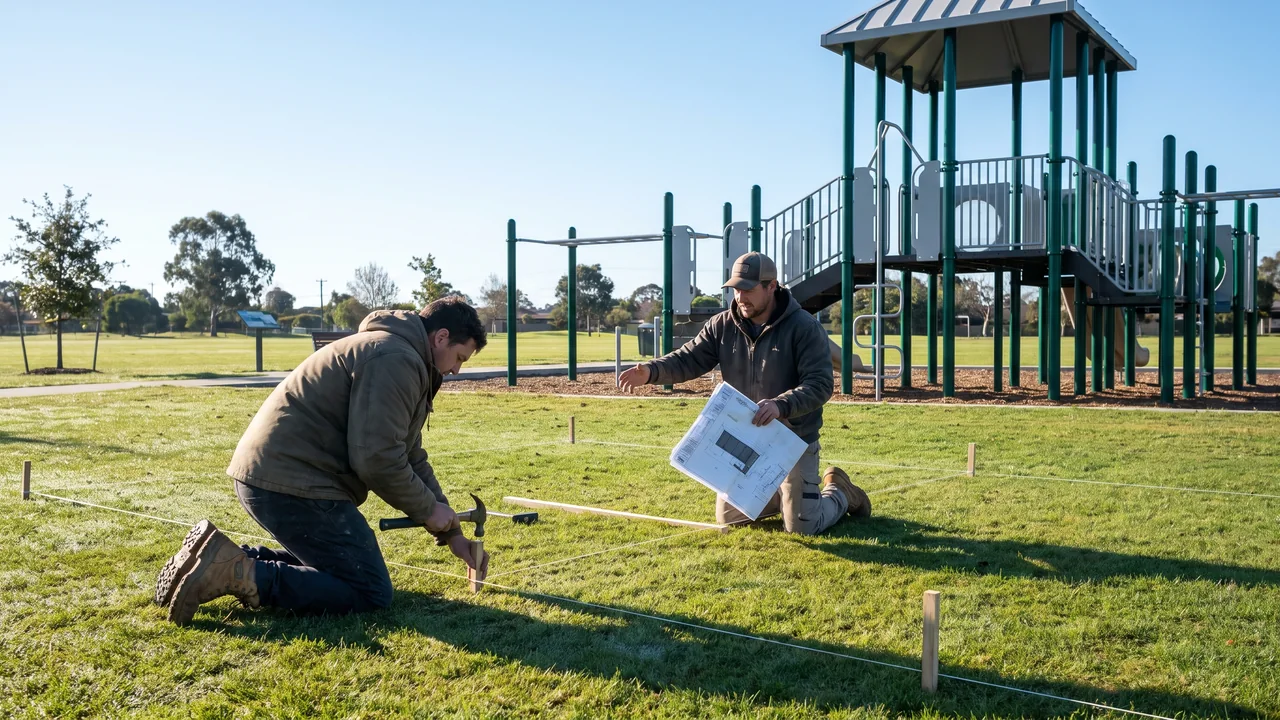

Two installers setting out footing positions on a grass site with string lines and stakes

On your site

By you or your installer

  • Excavation
  • Concrete footings
  • Local permits and inspections
  • Installation labor

With footing detail drawings in hand, your local installer can excavate, pour footings and apply for permits while production runs.

When you need a change after approval

The change goes onto a revised drawing that you approve, and your project manager confirms the loading date again, so you know where the change leaves your schedule before any part is made to it.

Change requestedRevised drawingYou approve the revisionLoading date confirmed again

Send your site plan, age groups and standard to Anna, Sales Manager. Your layout and itemized quotation come back within 3 working days.

+86 177 0272 7677

WhatsApp · Anna, Sales Manager
Reply within 24 hours on business days

06/ 13 · ProductionSteps 04–07

Production Sequence 20–30 Days Scheduled Back From One Loading Date

Playground equipment manufacturing on your project takes 20–30 days after drawing approval, for outdoor structures, soft play and trampoline courts alike. Every item, spring riders and fitness stations included, is made to your drawing on one commercial playground production schedule.

Cut, bend, weld Galvanize Blast, powder coat Pre-assembly QC + pack Rotomold QC + pack CNC-cut QC + pack Sew Trial fit QC + pack Partner QC inspection R1 R2 R3 R4 R5 Loading date Approval · day 0
20–30Days after approval · one loading date
Photo 1 Photo 2 Photo 3 Photo 4
  • R1Steel: cut, bend and weld · galvanize · blast and powder coat · pre-assembly · QC and packing
  • R2Rotomolding: slides, tunnels and roofs · QC and packing
  • R3Panel and CNC: HDPE panels · QC and packing
  • R4Soft play sewing: padding, covers and nets · trial fit · QC and packing
  • R5Partner factories (dashed): partner-built items · inspection by our QC

Sequence, not to scale · all rings start on the approval day

The order parts move in

  1. 01

    Approval day, in parallel

    Steel is cut, bent and welded into posts, frames and decks. Slides, tunnels and roofs are rotomolded from in-house steel molds. HDPE panels are CNC-cut. Padding, covers and nets are sewn. Partner factories start their items.

  2. 02

    Coating follows welding

    Welded steel is hot-dip galvanized at a partner plant, then blasted, powder coated and cured on the in-house line.

  3. 03

    Pre-assembly follows coating

    Outdoor structures are assembled complete in the pre-assembly yard. Soft play, trampoline court and ninja course frames are trial-assembled to check hole positions and connections.

  4. 04

    Final QC and packing

    Parts are checked against the packing list and packed in installation sequence.

  5. 05

    Loading

    Parts from the workshops and partner factories go into the same container plan.

How one date holds it together

Your project manager schedules every workshop and every partner factory back from the loading date set at approval. A partner-built item that fails inspection is remade or replaced before loading, so it does not ship late in a second container.

What you see during production

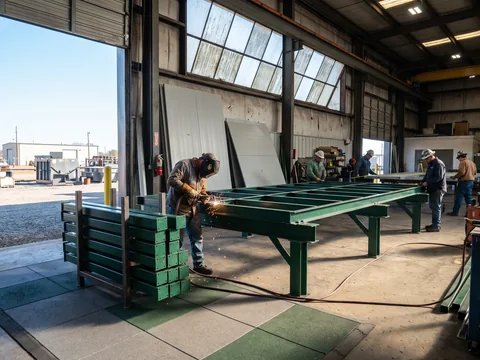

A welder joining a platform frame at production start
Photo 1 · production start

Powder-coated posts and deck frames after the curing oven
Photo 2 · after coating

A complete play structure standing pre-assembled in the factory yard
Photo 3 · pre-assembly or trial assembly

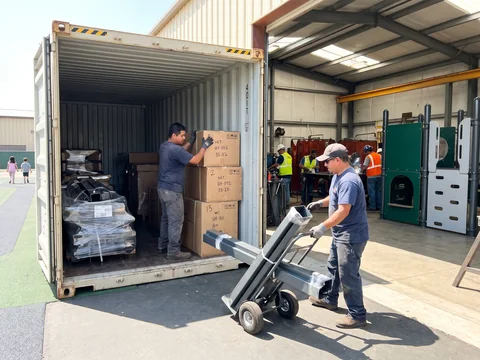

Numbered cartons being stacked into a container
Photo 4 · loading

Who checks the parts

A QC inspector checking a partner-built inflatable against a drawing

The QC team, independent of production, checks material, welds and coating, and inspects partner-built items before loading. How QC holds and releases parts is set out on the about page.

Handoff · Steps 04–07 → Playground equipment manufacturingSteel, coating, rotomolding, CNC and sewing, process by process, with the materials.Read the full process
07/ 13 · Confirmation pointsSteps 03 · 05 · 07

Your Three Confirmation Points Drawing, Pre-Assembly Video, Loading Plan

A project passes three points where you confirm before the work moves on. At each one you receive something you can check against your drawing.

1

Step 03Drawing approval

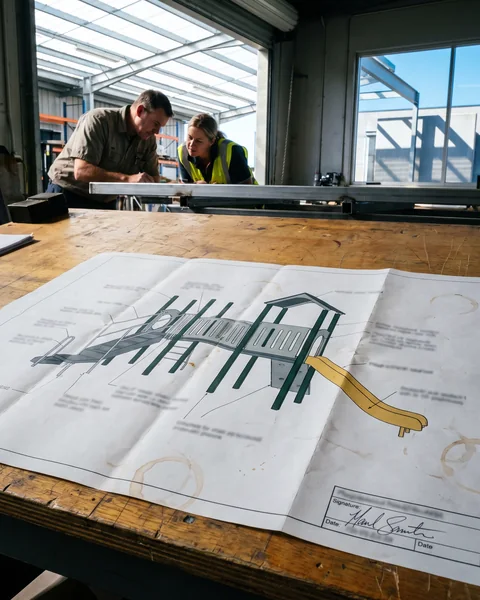

A printed approved playground drawing with a signed approval box

Your signature starts production and fixes the part numbers. What locks on the approval day.

2

Step 05 · before packingPre-assembly video of your own structures

A video frame of a pre-assembled structure: a bolted post connection with its part number label
1 · Full structure2 · Connections, close view3 · Part numbers, close view4 · Indoor frames, trial-assembled

You receive photos and video of your own structures, with close views of connections and part numbers to match against the installation drawing.

  • OutdoorStructures stand complete in the yard
  • IndoorTrial-assembled steel frames and padding test-fitted on sample sections, part numbers visible
  • TrampolineSample cells fully hung with bed and springs

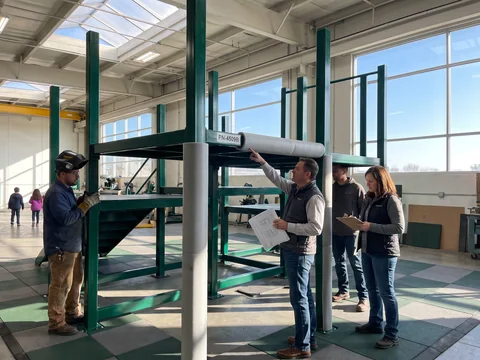

An indoor soft play frame trial-assembled with one padded sample section

Raise comments before packing. A part that needs correcting is corrected in the factory and refitted; the QC team signs off the assembled structure, and only then is it taken apart and packed. The full pre-assembly check.

3

Step 07 · before bookingLoading plan

40HQ · plan viewExample

In-housePartner-built

The plan shows 20GP or 40HQ containers and where each category and each structure's boxes sit. On mixed projects, play structures, surfacing, shade sails, inflatables and rides share one plan. You confirm it, then the container is booked.

What follows the last confirmation

Loading photos of each container are sent before it is sealed. Together with the pre-assembly video and the packing list, they show exactly what left the factory for your site.

Three times before the container leaves, you see your own project and can comment, so a problem is fixed in the factory yard.

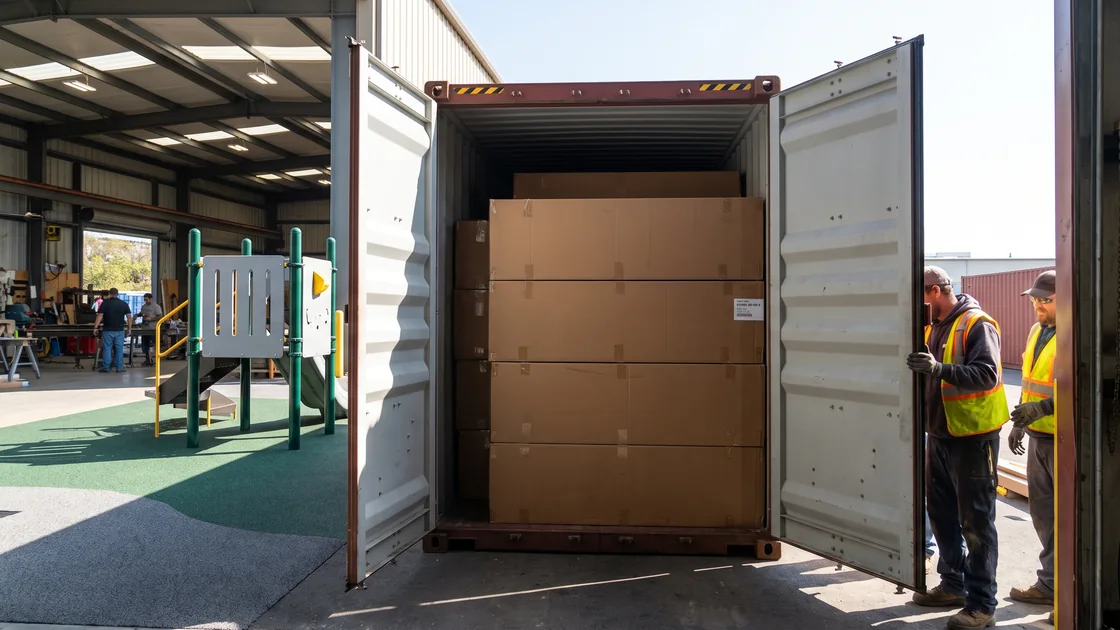

The open doors of a container with numbered cartons stacked to the doorway before sealingPhotographed before sealing

You see your own structures standing complete before a single box is packed.

Pre-assembly video
Your structure
Before packing
08/ 13 · One part numberSteps 03–08 · after

One Part Number Through Seven Records Following Post S2-021

Every part on your project carries one number from the approved drawing onward. Here is one post, S2-021, the twenty-first part of structure S2 on your layout, followed through your project.

What your installer does with the number

On arrival, each box is checked against the packing list. The post can be measured against the spec sheet for diameter and wall thickness, then set into its footing by the number on the installation drawing.

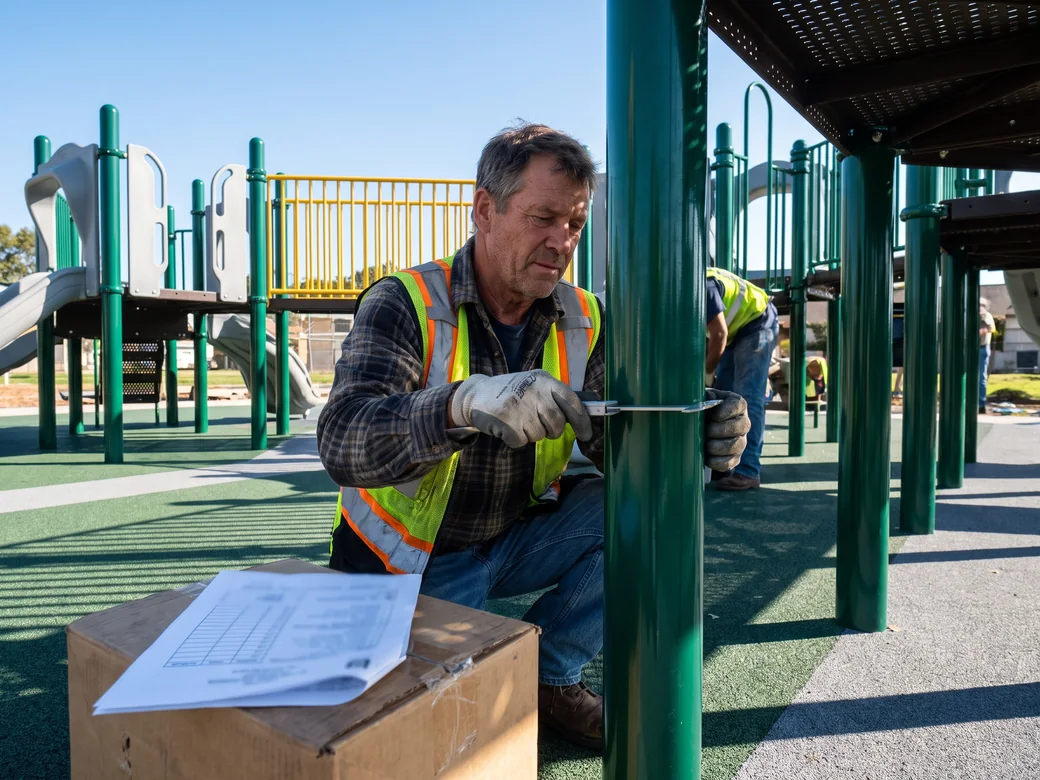

An installer measuring a steel post wall with a caliper beside a printed spec sheet

Where the number applies

Steel posts and frames, rotomolded slides, tunnels and roofs, HDPE panels, rope sections, soft play padding, nets and mats, and partner-built items all carry numbers keyed to their structure. A phase 2 order or a replacement slide is made to the same project file.

01

Installation drawing

Step 03S2-021
Ø1143.0 mm wallDeck · S2S2-021

When you approve the drawing, S2-021 is fixed as a Ø114 mm galvanized steel post with a 3.0 mm wall, in its position on structure S2.

Ø114 mm · 3.0 mm wall · galvanized + powder coated

02

Footing detail drawing

Step 03S2-021
GradeFooting size on your drawingS2-021

The same post has its concrete footing size on the footing detail drawing. Your installer can pour that footing during the 20–30 days of production.

Issued on the approval day · every post

03

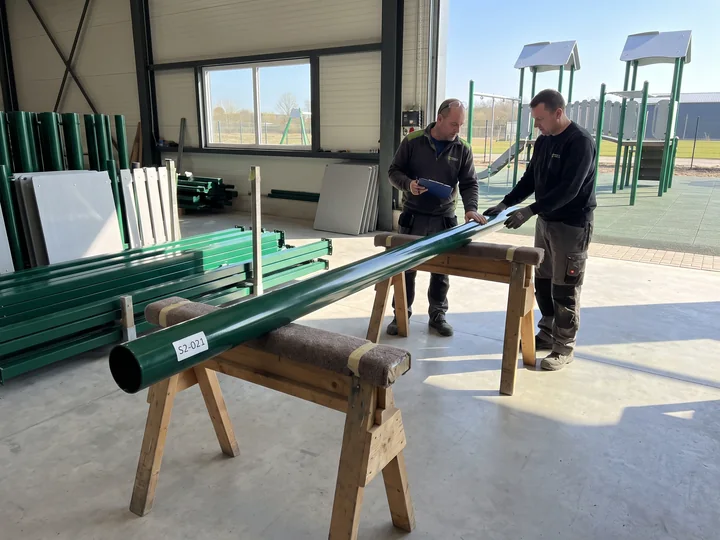

Progress photo · after coating

Step 04S2-021
Post S2-021 after powder coating, its part-number label visible

The post is cut and welded in steel fabrication, galvanized, then powder coated in the color on your drawing. You see it in the after-coating photo update.

Photo 2 of 4

04

Pre-assembly video

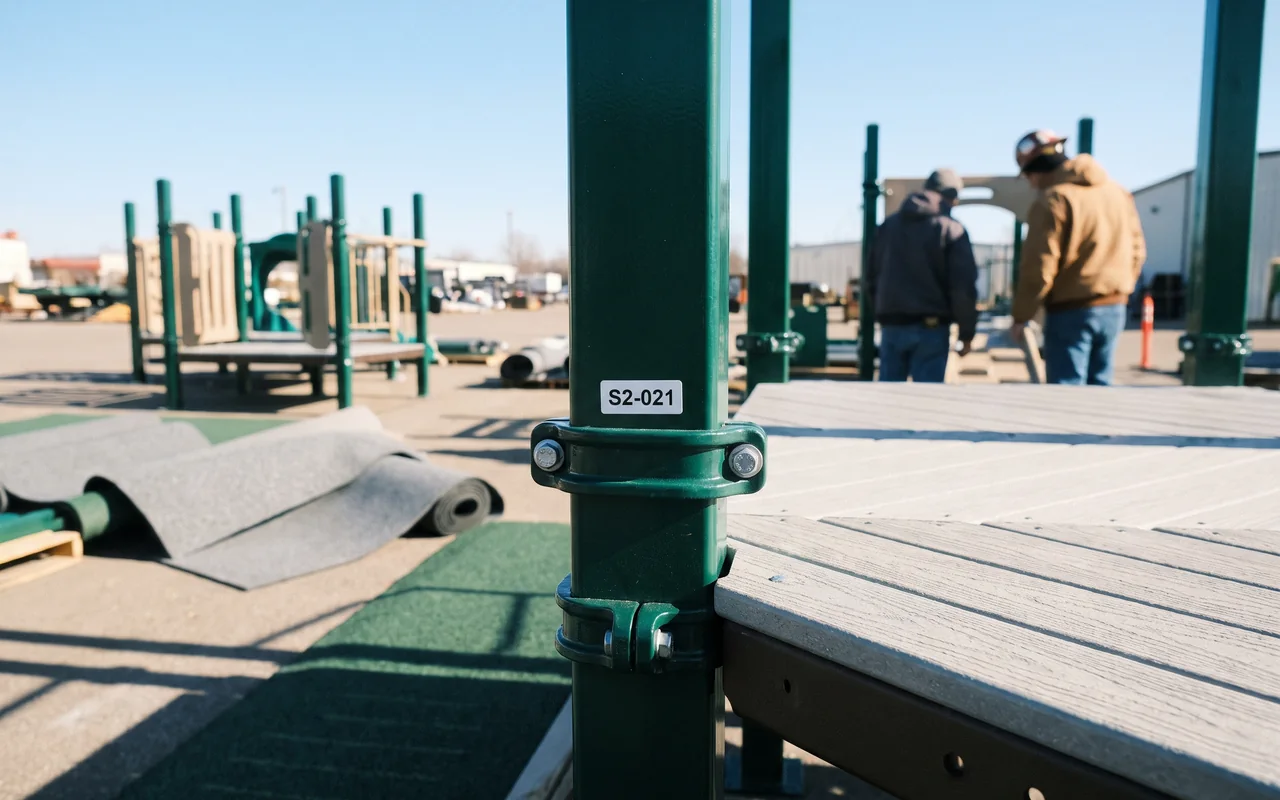

Step 05S2-021

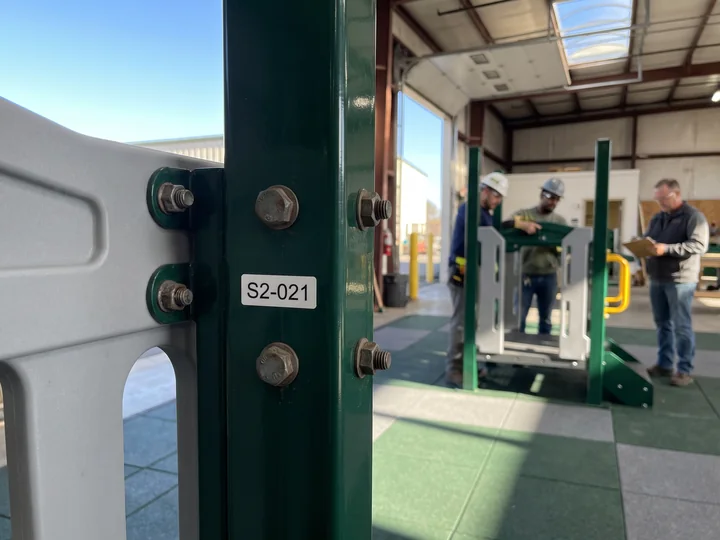

Close view of post S2-021 bolted into structure S2 during pre-assembly

S2-021 is bolted into structure S2 in the yard. The video shows close views of its connections and its number. If you comment on it, the fix is made and refitted before packing.

Confirmation point 2

05

Packing list and label

Steps 06–07S2-021

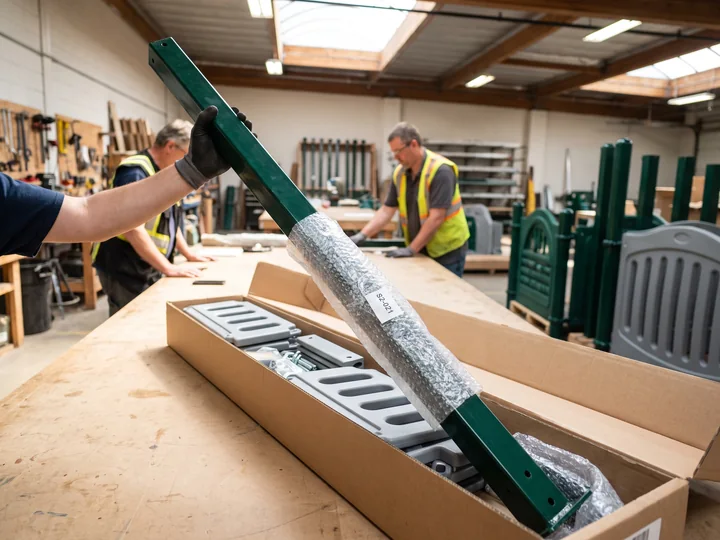

Post S2-021 wrapped in bubble film with its label, going into a carton

After QC sign-off, the post is labeled S2-021, wrapped in bubble film and cartoned with the parts your installer needs for structure S2. The packing list shows the number and the box; the loading plan shows where structure S2's boxes sit.

Packing list · S2-021 · post · box for structure S2

06

Project package · part list

Step 08S2-021
PartS2-021 · post Ø114 × 3.0
StructureS2
CoatingThickness · on file
AdhesionCross-hatch · on file
WallUltrasonic · on file

S2-021 appears on the part list in your electronic project package, next to the QC readings for the coating batch it came from.

07

Replacement request

Years laterS2-021
A phone showing a photo of a damaged playground post

If S2-021 is damaged years later, send a photo and its number. QC confirms it against your part list, and a replacement is made to the same dimensions on your installation drawing. Replies come within 24 hours on business days.

Photo + S2-021 → QC checks your part list → same dimensions

09/ 13 · Project packageStep 08

Shipping Documents and Your Electronic Project Package

When the container sails, you receive two sets of files together: the shipping documents and an electronic project package with everything your project was built to.

Your-project / electronic-project-packageSent with the shipping documents
01Approved-drawings/
02Installation-drawings/
03Footing-detail-drawings/Every post
04Part-listKeyed to part numbers
05Packing-list
06QC-readings/For your project
Coating-thicknessOn file
Cross-hatch-adhesionOn file
Ultrasonic-wall-thicknessOn file
07Photos-and-video/
Pre-assemblyPhotos + video
LoadingEach container
08Third-party-test-reportIf ordered for the project

Shipping documents

A bill of lading, commercial invoice, packing list and certificate of origin on a desk
  • Bill of lading
  • Commercial invoice
  • Packing list · keyed to part numbers
  • Certificate of origin · on request

Who uses the package

A specifier adding a project package PDF to a submittal folder on a laptop

Specifiers

Attach it to submittals and approved-supplier files.

Dealers

Hand it to your client or tender board.

FEC owners

Keep it for insurers and inspectors.

Your installer

Works from the installation drawings and part list.

The same package is kept on file under your project, so a reorder, a phase 2 or a replacement part years later is made to the same drawings and part numbers. How QC readings are taken is described on the about page.

10/ 13 · Arrival and installationStep 08

Arrival and Installation Footing Drawings, Numbered Parts and Video Support

By the time your container arrives, your site can already have its footings in, poured to the footing detail drawings issued at approval. Playground installation support runs from the same drawings.

A park site with a grid of poured concrete footings and a container arrivingS2-021S1-014Footings poured during production
Installers unloading numbered cartons in build order
Boxes out in build order
An installer on a live video call while a colleague sets a post
Live video support
A spare hardware kit laid out on a tailgate
Spare hardware kit

What arrives

  • Every part numbered to your installation drawing, packed in installation sequence
  • Anchoring hardware for every post
  • A spare hardware kit, with spare springs for trampoline orders
  • Soft play padding, nets and mats labeled with their structure numbers

How your installer builds

Boxes come out in build order and are checked against the packing list. Structures go up from numbered parts that have already been assembled once in the factory yard.

Support

  • Installation drawings
  • Step-by-step video guides
  • Live video support
  • An optional on-site supervisor, quoted separately

Sea freight

Sea freight time is quoted per destination.

Handoff · Step 08 → Playground equipment installationFootings, anchoring and building step by step.Read the full process
11/ 13 · Mixed-category projectsSteps 02–07

Mixed-Category Projects Workshop and Partner-Built Items on One Timeline

A complete site often mixes equipment from the workshops with inflatables, rides, splash pad parts, surfacing and shade fabric from partner factories. On your timeline they move as one project.

  • A commercial inflatable play unit on a lawnPartner-built · inflatables
  • An electric kiddie ride in an indoor venuePartner-built · kiddie rides
  • Stainless splash pad nozzles and a manifoldPartner-built · splash pad parts
  • Stacks of rubber tiles and rolled EPDMPartner-built · surfacing
  • Rolls of shade sail fabric with stainless corner ringsPartner-built · shade fabric
  • A trampoline jump bed with galvanized springsPartner-built · jump beds + springs
  1. 01Drawn on your layout
  2. 02Priced on the same quotation
  3. 03Ordered on the approval day
  4. 04Numbered on your part list
  5. 05Inspected by our QC against your drawing
  6. 06Loaded to the same container plan

Your project manager deals with the partner factories, so you keep one contact and one loading date. Which categories come from where is listed on commercial playground equipment and indoor playground equipment; how partner factories are approved is on the about page.

12/ 13 · Buying routesSteps 01–08

Buying Routes on the Same Timeline Dealer, Installer or Direct

Playground dealers and installers, parks departments, public schools and specifiers, and FEC founders opening indoor venues all run through the same eight steps, drawings and confirmation points.

A playground dealer showing a 3D render to a client on a tablet
Route · dealer

Your brand, your client

Files unbranded or under your brand, with the project registered under your name. End-client details stay confidential.

An installation crew around a printed installation drawing
Route · installer

Files for your bid

Layout, renders and quotation for your bid, under your brand, with the project registered under your name.

A parks facility manager checking a tablet on a playground site
Route · direct

Parks, schools, venues

Order directly or through your local installer, and receive the same project package.

13/ 13 · Project start checklistStep 01

Project Start Checklist Site Plan, Age Groups, Theme, Standard and Buying Route

Send what you have, and your project manager asks for the rest. The full list by project type is on the contact page.

A tape measure across an empty grass site while a phone takes a site photo
  1. 01

    Site

    Site plan or dimensions, and site photos.

  2. 02

    Users

    Age groups and expected visitors.

  3. 03

    Look and budget

    Theme and colors, and your budget range.

  4. 04

    Rules and route

    The standard you build to, and your buying route: dealer, installer or direct.

Indoor venue? Switch above for four more items.

Indoor venues add

Column positions, clear ceiling height, entrances and fire exits.

01 Site plan · you are here

Send the site plan and the standard. The layout and itemized quotation come back within 3 working days.
